Change order request vs. change order

A change order request is the contractor’s priced proposal asking the owner to approve a change; a change order is the signed agreement that actually adjusts the contract sum and time. Two other documents sit around them: a proposal request asks the contractor for a price, and a construction change directive orders the work before the price is agreed.

Published · Amounts calculated with the Renpavo change order form; all projects are fictional

Four documents, compared

DocumentWho starts itWhat it doesChanges the contract sum?
Proposal request (AIA G709)Architect, for the ownerDescribes a possible change and asks the contractor for its cost and time within a set number of daysNo — AIA: “The form does not modify the contract for construction.”
Change order request (often COR or PCO)ContractorPrices the change and asks for approval by a dateNot until the owner accepts it
Change order (AIA G701)Drafted by either side; signed by owner, architect and contractorRecords the agreed change in work, sum and timeYes, on signature
Construction change directive (AIA G714)Architect, authorized by the ownerOrders the work to proceed while the price or time is still disputedNot yet; a change order follows once the adjustment is agreed

The sequence is usually proposal request → change order request → change order. A construction change directive is the detour when the work cannot wait for agreement: AIA’s G714 instructions say the contractor “shall promptly proceed with the changes directed”, and that the architect prepares a change order when the owner and contractor agree on the adjustment.

The same change, written both ways

The clinic change from the worked example — sheet vinyl in two exam rooms, two dedicated circuits, a paint credit — starts as a request. In Renpavo the only difference is the Document selector at the top of the form:

The top of the Renpavo form with the Document selector set to Change order request and the number COR-003.
The title of the sheet is the document type. Switching it changes wording, never amounts.

What changes on the page:

What stays the same: every amount. The request and the later change order both show $3,501.00 net cost, $420.12 markup, $112.14 tax and +$4,033.26 on line 4. The owner approves exactly the numbers that will later be signed.

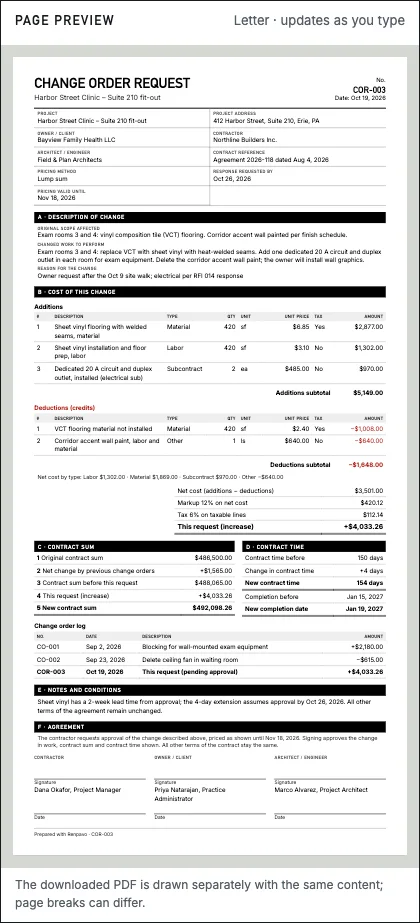

Preview of the change order request COR-003: title Change Order Request, pricing method lump sum, response requested by Oct 26, 2026, pricing valid until Nov 18, 2026, and the agreement paragraph asking for approval.
The request carries two dates the change order does not need: when an answer is needed and how long the price holds.

Why a request needs two dates

The clinic request says “response requested by October 26” and “pricing valid until November 18”. They do different jobs. The response date protects the schedule: the notes explain that sheet vinyl has a two-week lead time, so the 4-day extension only holds if approval arrives by October 26. The validity date protects the price: if the owner signs in December, the contractor is not bound to October’s material quotes. A G709 proposal request has a similar clock in the other direction — AIA’s G709 FAQ notes the architect specifies the number of days within which the contractor must submit its proposal.

Pending requests and the contract sum

A request never belongs in line 2 of a change order. Line 2 is the net change by previously authorized change orders (G701 instructions). Track open requests in the same log as change orders, with a status, and total them separately — the change order log template does exactly that, so pending exposure is visible without inflating the contract sum.

Questions

Does a signed change order request change the contract?

It depends on your contract’s change procedure: it may accept an owner-signed request as the change order or require a separate change order document. Renpavo’s request wording says that signing approves the change in work, sum and time shown, so read your contract’s change clause before using it as the final document.

Can the price change between the request and the change order?

Yes. Prices in a request are an offer, which is why the request carries a “pricing valid until” date. If approval comes later, update the prices, issue a revised request (for example COR-003R1), and only then write the change order.

Is a proposal request the same as a change order request?

No. In AIA’s documents the proposal request (G709) goes from the architect to the contractor to obtain a price; AIA states it “does not modify the contract”. The contractor’s answer to it is the priced proposal, which many teams call the change order request.
