Change order log template with a running contract sum

A change order log lists every change on a job — number, date, description, status, amount and days — and keeps a running contract sum that only approved change orders move. Download the blank log below, or export a filled one from the change order form.

Published · Amounts calculated with the Renpavo change order form; all projects are fictional

Download the change order log (.xlsx) All blank templates

The columns, and the one that decides

ColumnContentWhy
A · Change order no.CO-001, COR-004, …Requests and change orders in one numbered list
B · DateIssue or approval dateSort and audit
C · DescriptionOne line; the full scope stays on the change orderFind the document quickly
D · StatusApproved, Pending, Rejected, Void (drop-down)Decides whether the row moves the contract sum
E · Amount ±Positive for an increase, negative for a decreaseLine 4 of that change order
F · Days ±Change in contract timeRunning time extension
G · Contract sum after (approved)=IF(E8="","",N($G$5)+SUMIFS(E$8:E8,D$8:D8,"Approved")+…)Original sum plus approved amounts up to that row

Most free logs add every amount down the column. That inflates the contract sum the moment someone records a pending request with its price. Here the status column carries the logic: column G sums only rows marked Approved (plus the row an export marks This change order), and two totals at the bottom separate the approved net change from the pending exposure.

Worked example: a fire station

Cedar Point Fire Station 6 has an original contract of $3,865,000.00. Three change orders are approved, a time-and-materials request for rock at footing F-7 is pending, and one owner request was priced and rejected:

No.DescriptionStatusAmountContract sum after
CO-001Add sleeve for future fiberApproved+$3,120.00$3,868,120.00
CO-002Delete apparatus bay trench drain extensionApproved−$4,870.00$3,863,250.00
CO-003Upgrade generator transfer switchApproved+$11,260.00$3,874,510.00
COR-004Rock removal at footing F-7 (time and materials)Pending+$9,499.00$3,874,510.00 (unchanged)
COR-005Add epoxy floor to the hose tower (owner request)Rejected—$3,874,510.00 (unchanged)

Approved net change: +$9,510.00. Pending: +$9,499.00. The contract sum stays at $3,874,510.00 until COR-004 is approved — and that figure is exactly what line 3 of CO-004 must show, because the G701 instructions define line 2 as the net change by previously authorized change orders. The log and the next change order check each other.

Exporting a filled log from the form

When you list earlier change orders in Part C of the change order form, More → Change order log (.xlsx) writes them into this layout with the current document as the last row — marked This change order, or Pending if the document type is a request — and 15 empty rows for the next ones. The same list prints as a small log table on the PDF itself.

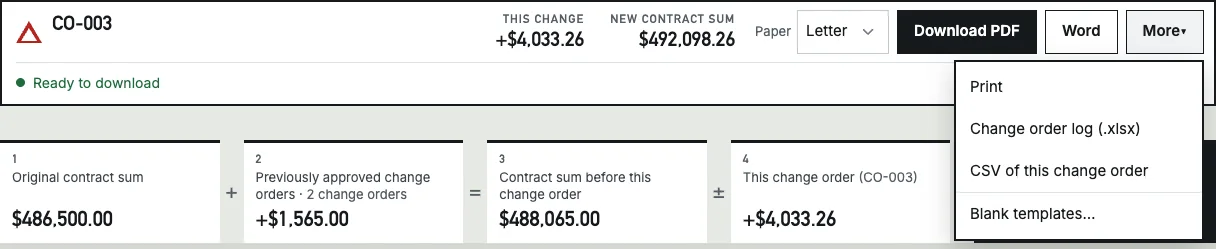

The Renpavo toolbar with the More menu open: Print, Change order log (.xlsx), CSV of this change order, Blank templates.
The log export sits under More, next to Print and CSV.

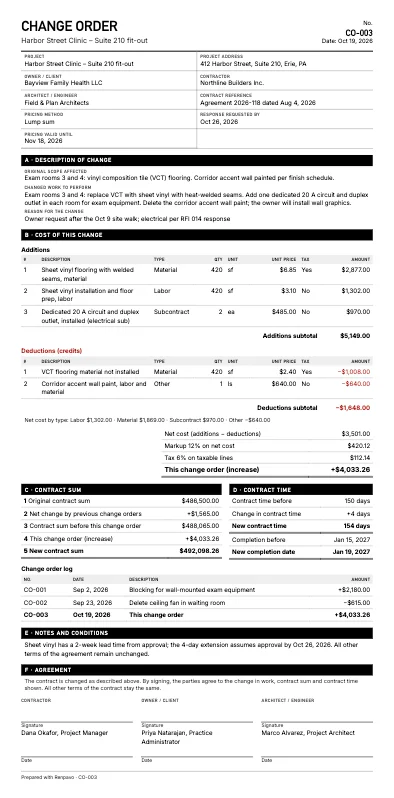

Printable change order preview ending with a change order log table: CO-001 +$2,180.00, CO-002 −$615.00 and CO-003 +$4,033.26 in bold.
The printed change order carries its own short log, so the owner sees the history behind line 2 without asking for it.

Three habits that keep a log honest

  1. Never edit an approved amount. If an approved change is corrected, add a new change order for the difference. The log then reconciles with the signed documents line by line.
  2. Record days in the same row. G701 asks for each change order’s change in contract time; the days column adds those up into the running extension, so a missed or doubled extension shows.
  3. Reconcile at every pay application. The approved total in the log should equal the change order line on the payment application. If it does not, a change order is missing from one of them.

Questions

Should rejected change orders stay in the log?

Yes. Keep the row with status Rejected or Void so the numbering has no gaps and the history of what was asked for stays visible. The template’s formulas ignore those rows when they total the contract sum.

Does the log replace the change orders themselves?

No. The log is an index and a running total. The signed change order, with its description and cost breakdown, is still the record of what was agreed.

Does the template work in Google Sheets?

It uses only IF, N, SUMIFS and a drop-down list for the status, all available in Google Sheets. Upload the .xlsx to Google Drive and open it with Google Sheets.
